2017-2022 Bond Project: Broadway Street Corridor (East Houston Street to East Hildebrand Avenue)
2017-2022 Bond Project: Broadway Street Corridor (East Houston Street to East Hildebrand Avenue)
The Lower Broadway Corridor Project includes improvements such as roadway reconstruction, curbs, sidewalks, driveway approaches, underground drainage, ADA wheelchair ramps, pedestrian lighting and amenities, landscaping, and utility upgrades. Substantial completion for this project will be Summer 2024.
Project Type: Streets, Bridges & Sidewalks
Phase: Construction
Project Contact: Joey Doctor, (210) 207-8415
Estimated Construction Timeline: Summer 2020 - Summer 2024
Estimated Timeline Construction Seasons are identified as: Winter (January, February, March), Spring (April, May, June), Summer (July, August, September), and Fall (October, November, December.)
Project Budget: |
| ||
2017 General Obligation Bond (Street) | $42,000,000.00 | ||
AT&T Contribution | $4,000,000.00 | ||
CPS Energy | $14,657,973.41 | ||
San Antonio River Authority | $396,195.37 | ||
San Antonio Water System | $8,226,091.53 | ||
Tax Increment Reinvestment Zone | $43,000,000.00 | ||
Tree Preservation Fund | $965,000.00 |
Total | $113,245,260.31 |
Construction Phasing (Roadway):
- Avenue B / N. Alamo Bike Lanes
- Roy Smith to Jones
- Brooklyn to Jones
- 3rd St. to Brooklyn
- Pecan St. to 3rd. St.
- E. Houston to Pecan St.
- Final Asphalt Overlay

Project Limits:
SUPPORT YOUR LOCAL SMALL BUSINESSES: https://www.sanantonio.gov/EDD/Programs-Grants/Paving-The-Way
NOTE TO BUSINESS OWNERS:
If your business is currently or expected to experience construction in your area please visit the City of San Antonio's Construction Toolkit. This guide helps business owners understand and prepare for City-initiated construction projects.
Business Outreach Specialist: Gabby Tello, 210-207-4688
Learn more about City projects in your neighborhood and across San Antonio. The City of San Antonio’s digital dashboards encompass a wide range of projects, including streets, drainage, parks, and facilities.
Lower Broadway - Paving Notice
The contractor will begin final paving operations as early as the week of September 30, 2024, with 3 to 4 full rolling block closures during operations. Detours will lead motorist to N. Alamo and Avenue B. The Paving work will start at Broadway & Roy Smith and move south to Houston Street. Please Note: All street parking will be restricted during rolling block closures. Paving of the entire Broadway corridor is expected to be completed by mid-October 2024. After paving is completed, the entire roadway will be striped, and expected to be completed by October 26, 2024. The roadway striping work will have mobile crew operations, and lanes will be open and accessible to traffic with flagmen. All work is weather permitting.
Please see helpful reminders below during the paving operations. We appreciate your patience as this project is reaching the last phase of work.
Reminders during Paving Operations:
- Vehicles should not be parked on the street. If vehicles are in the path of the project and no one is available to move it, it will be towed to one of the nearby streets
- Traffic detour barricades and signs will be provided to guide traffic through as needed
- Paving operations will be during the day, from sun-up to sun-down
- In the event of adverse weather, environmental conditions, unforeseen equipment issues, or schedule conflicts, work will likely be rescheduled as soon as conditions permit

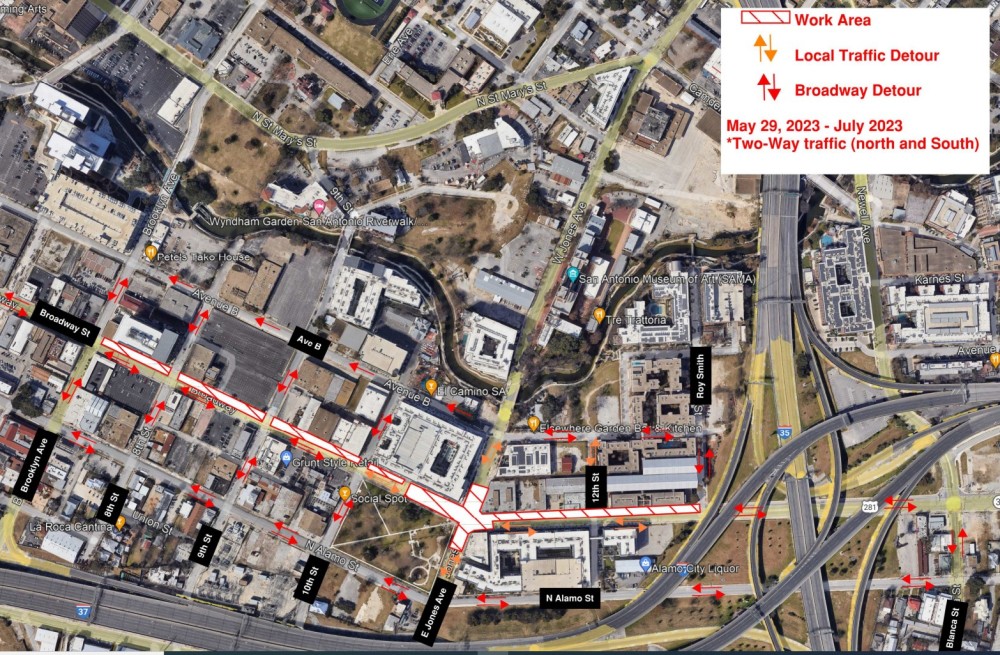

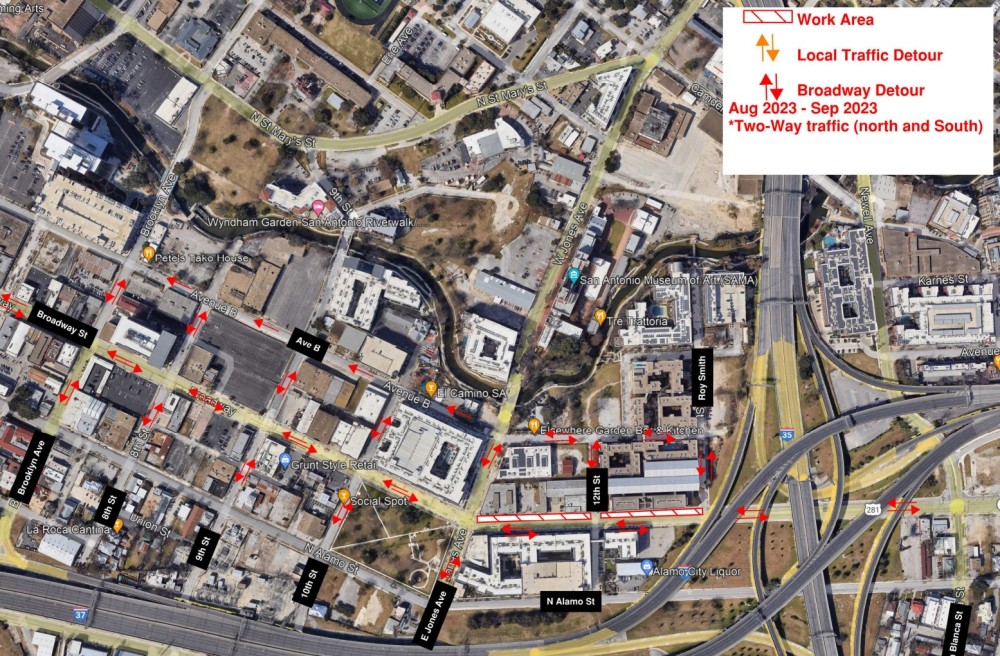

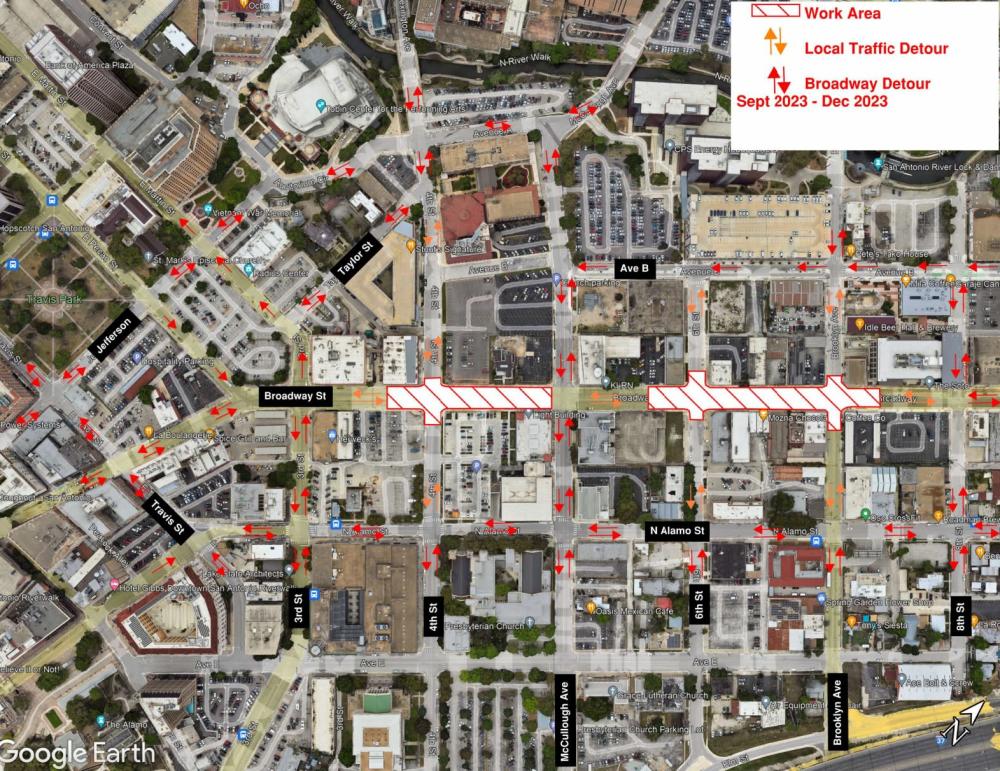

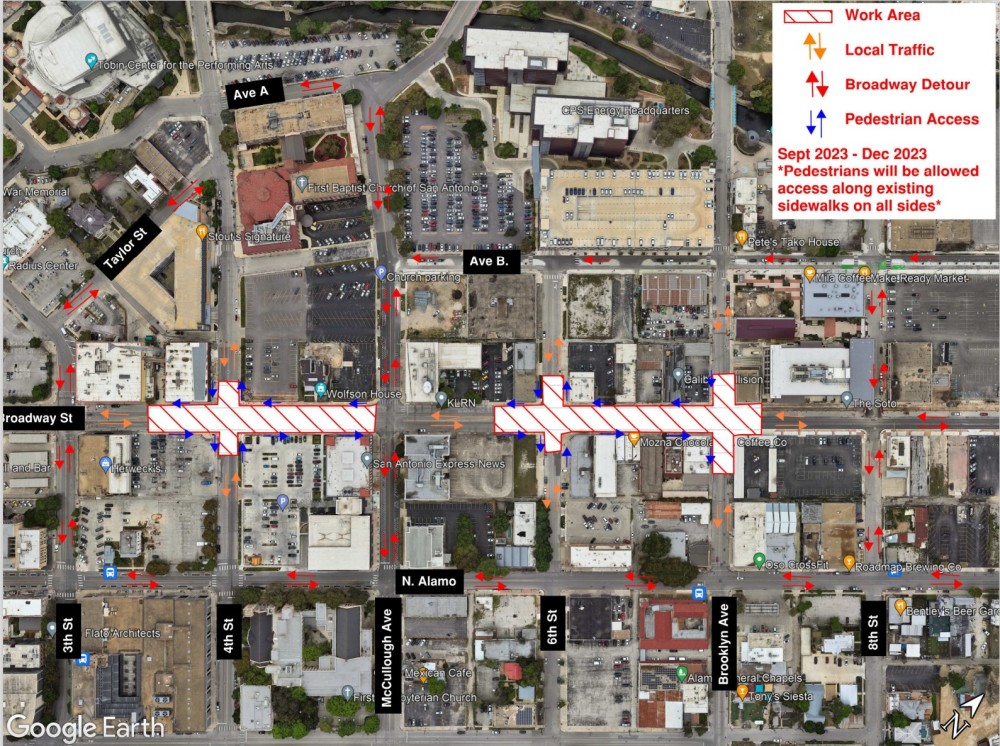

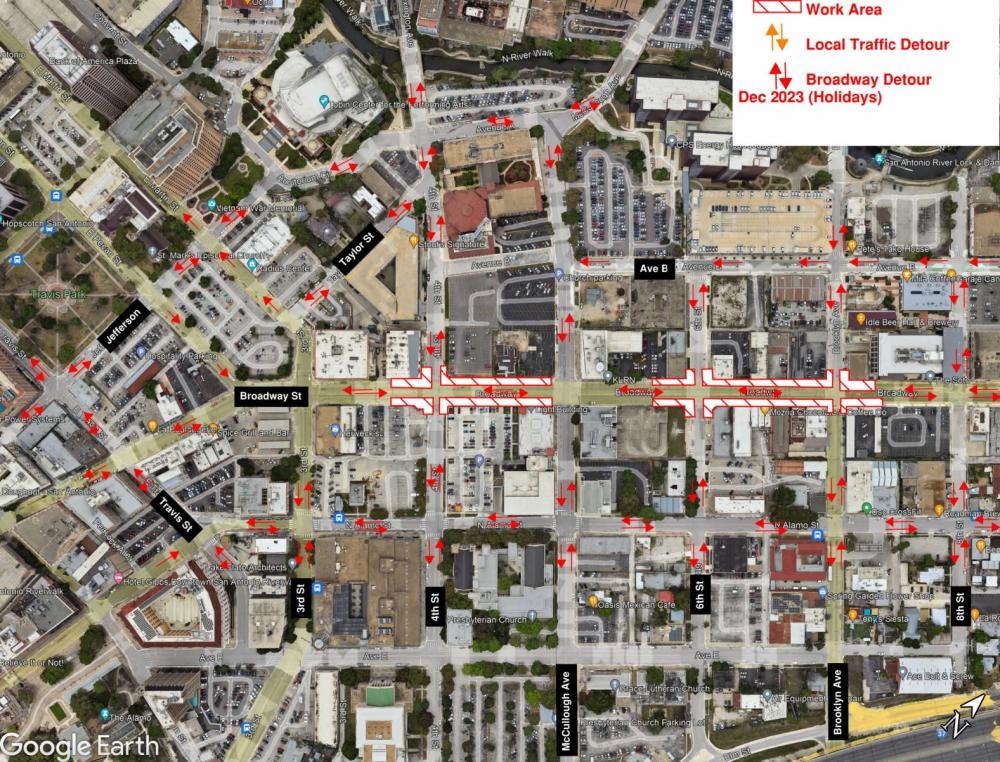

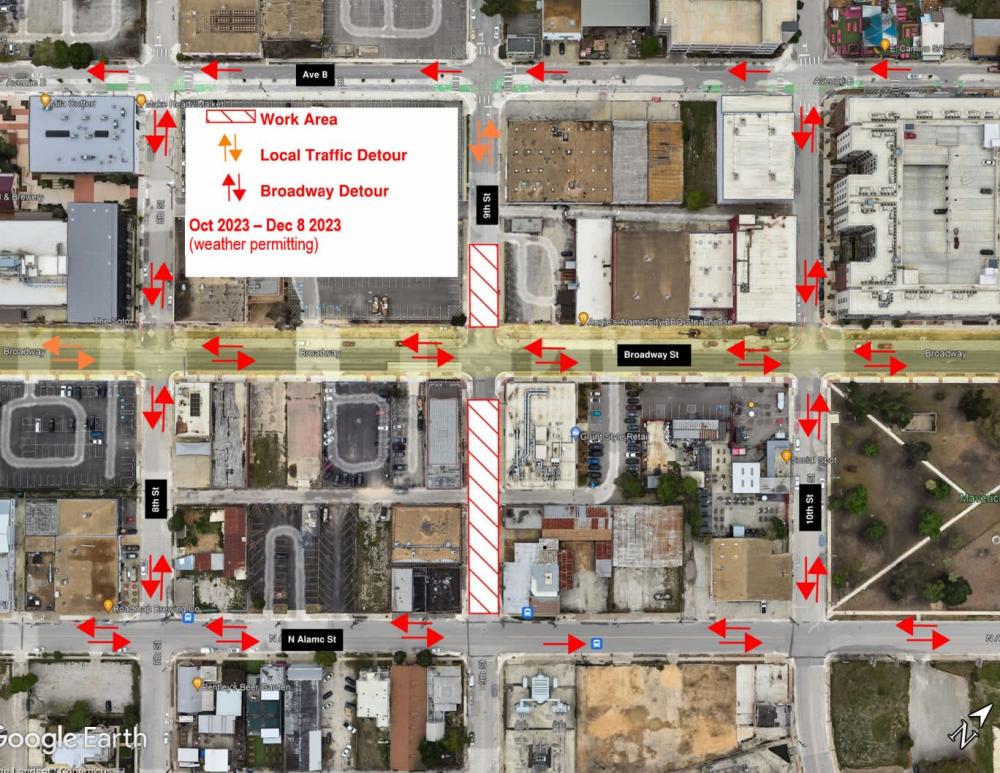

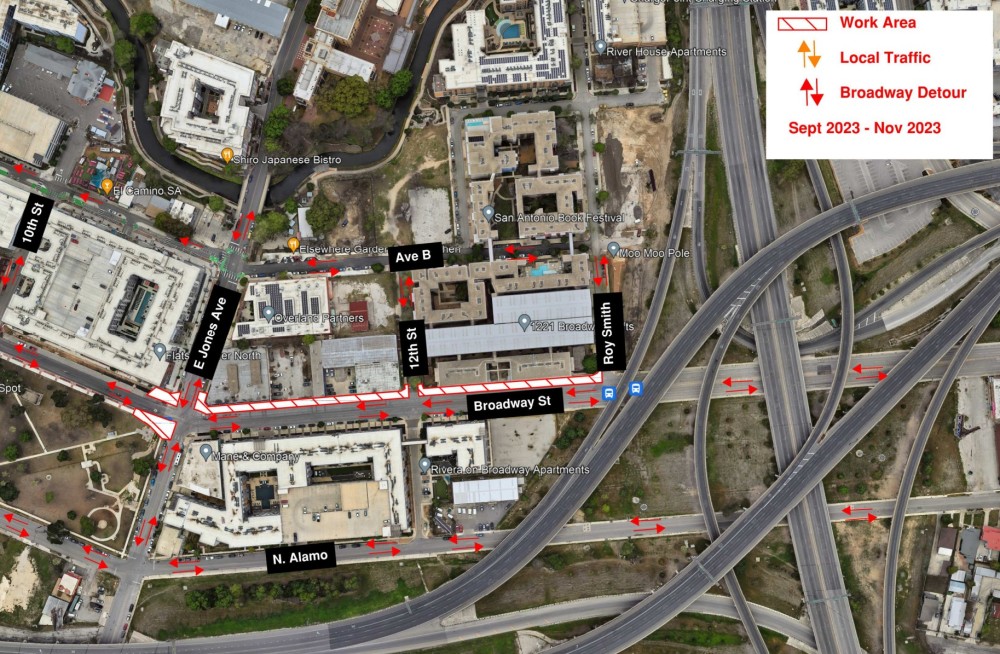

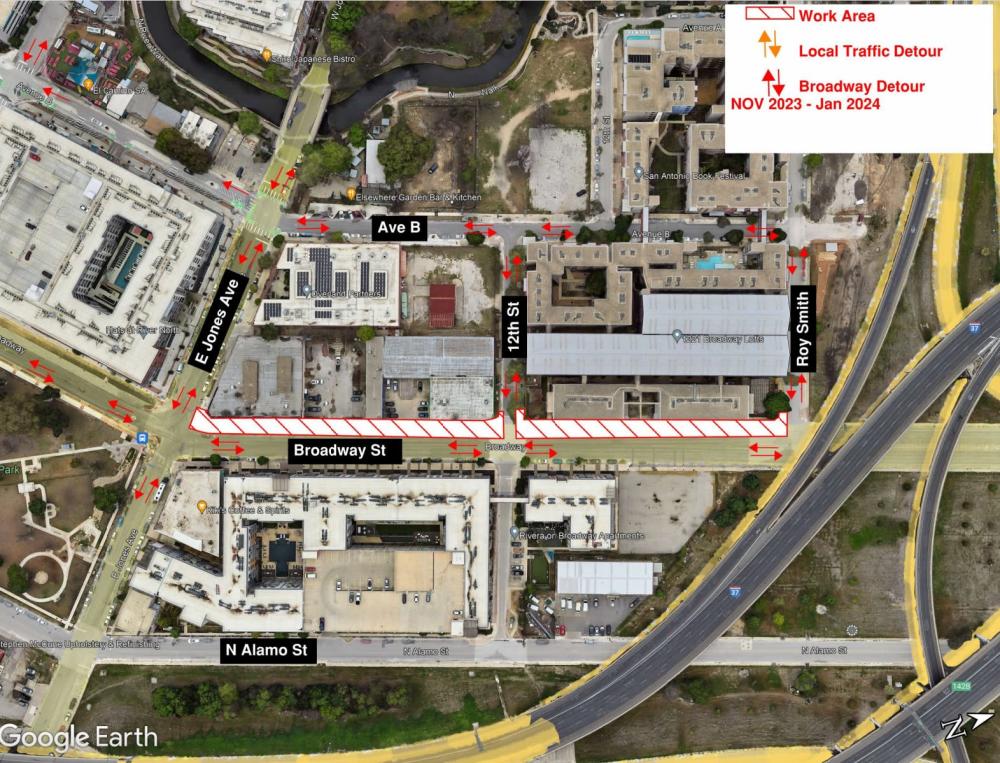

Paving Map and Detours
Construction Updates:
Broadway (Brooklyn Ave. to Roy Smith)
- Reconstruction continues thru September 2024, including lighting, landscaping, signage, and final paving.
- Two-Way traffic northbound and southbound is opened, and will be maintained.
Broadway (Brooklyn Ave. to Pecan)
- Reconstruction continues thru September 2024, including sidewalks, brick paver installation, tree installation, lighting, landscaping, signage, and final paving.
- Two-Way traffic northbound and southbound is opened, and will be maintained.
Project Notes:
- Contractor Sundt Construction continues reconstruction on the Broadway Corridor Lower Segment (E. Houston St. to IH-35) project, and bike lane work on the Avenue B and N. Alamo Bike Lane project.
- The entire project corridor is open to vehicular traffic.
- Pedestrian access is available throughout the corridor, except for the blocks of Broadway between McCullough Ave. and Pecan, pedestrian detour signage is posted in this area.
- Avenue B, McCullough, and N. Alamo bike lanes are completed.
- All work is weather permitting, construction scheduling adjusted daily as needed by Sundt.
